Data Center Pause Advances
Rutherford County moved one step closer to a one-year pause on data center development, but it has not adopted one. On October 12, the Rutherford County Regional Planning Commission voted to recommend a moratorium on new data center land-use applications in unincorporated Rutherford County. The final decision belongs to the County Commission. As of Monday morning, October 19, that vote has not been scheduled on a published agenda.
For land, industrial and utility-minded investors, this is a rules-before-the-fight story. County staff told the Planning Commission in September that there were no pending applications or inquiries for data centers in the unincorporated county. The county is writing its rules before a project arrives.
What passed on October 12
After a public hearing and discussion that ran about an hour and a half, the Planning Commission approved the draft moratorium resolution with changes to its definition. On the roll call shown in the RCTV meeting video, every commissioner who answered voted yes, and the chair declared that the motion carried. WGNS described the vote as unanimous.
Two changes matter most:
No size threshold. The draft covered facilities with more than 20,000 square feet under roof. That line was struck, so the definition covers a building or group of buildings whose principal use is operating computer systems, servers, data storage or related computing equipment, at any size.
More uses named. Commissioners added crypto mining, blockchain and quantum computing, plus catch-all language for similar technologies. When a commissioner asked whether AI was covered, members answered that the "similar technology" language would capture it.
The county attorney recommended keeping the definition broad, without electricity or water thresholds, and keeping the existing exclusions for telecommunications facilities such as switching facilities and central offices. The draft also excludes computer and server equipment that is incidental to another permitted use, like a business's server room; that exclusion was not among the changes made. The amended resolution text has not been posted, so investors should confirm the final wording when it appears.
What the resolution would do
Per the draft in the October 12 agenda packet, the County Commission would place a temporary one-year moratorium on accepting and processing any new land-use application for a data center in any zoning district subject to the county zoning ordinance, including planned unit development (PUD) applications. The pause would end automatically on the 365th day after passage unless the Commission ends it sooner or extends it. The effective date is still blank in the draft.
It applies only where the county controls zoning. Murfreesboro, Smyrna and La Vergne set their own rules, a point a county commissioner made to the audience right after the vote.
What is still pending
A recommendation is not law. County planning staff explained the path at the meeting:
The Public Works & Planning Committee takes it up first. It votes on the planning report, not on the resolution itself.
The full County Commission must hold its own public hearing, advertised at least 15 days in advance, and then vote.
The resolution can still be amended at the County Commission.
The next official dates
The County Commission's October 15 agenda lists the next Public Works & Planning Committee meeting for Tuesday, November 3, at 5:30 p.m. in Room 205, and the next regular County Commission meeting for Thursday, November 12, at 6 p.m. The October 12 Planning Commission agenda says the rezoning and regulation amendment requests heard that night "will be considered at the November 12, 2026 Board of Commissioners meeting unless deferred or withdrawn."
Neither date has a published agenda listing the moratorium yet, so treat November 12 as the earliest likely vote, not a confirmed one. One timing note: a county legal notice had advertised an October 15 Commission hearing on the moratorium, and two local outlets repeated that date. The moratorium was not on the published October 15 agenda, and the chapter list on the county's video of that meeting shows no moratorium item.

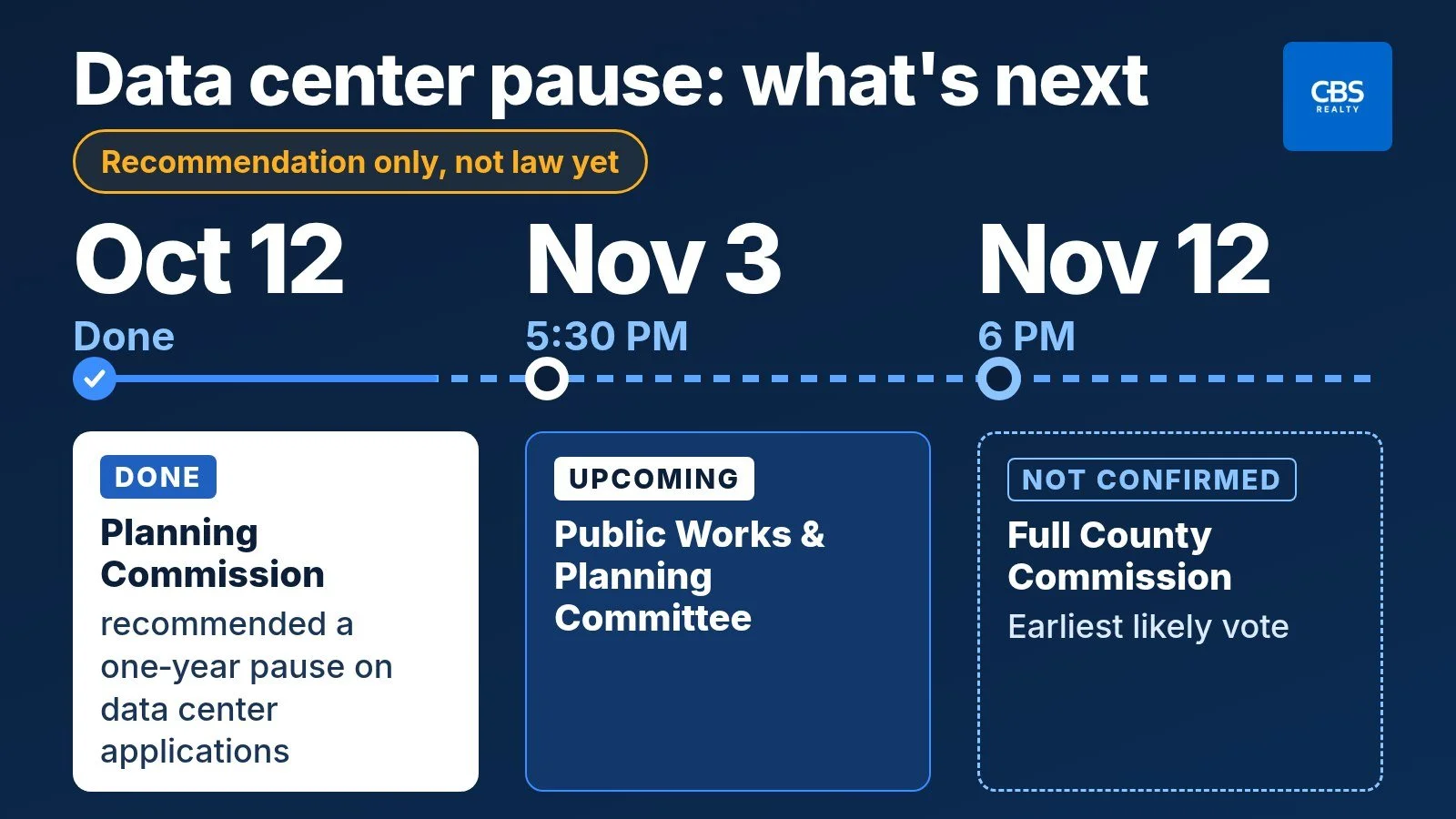

Approval path for the proposed moratorium. Sources: Rutherford County Regional Planning Commission October 12, 2026 agenda packet and RCTV meeting video; Rutherford County Board of Commissioners October 15, 2026 agenda.
Why the county wants a pause
The draft resolution cites energy consumption, noise and land-use compatibility, and says current county rules were not written with high-impact computing uses in mind. Draft September 28 minutes in the packet say staff consulted Middle Tennessee Electric, Consolidated Utility District and the county IT director, and that a data center would generally go through the PUD process today. Staff also noted that more than 90 percent of the unincorporated county is zoned residential, so a data center would likely need a rezoning or planned development approval anyway.
Not everyone on the commission was convinced a pause adds much. MTSU Sidelines reported that Commissioner Michael Shirley asked, "What does a moratorium give us that our current regulation don't already provide?" Planning Director Doug Demosi argued, per the same report, that a moratorium would put staff in a better position to react while regulations are written.
What land, industrial and utility investors should watch
The final definition. "Principal use" is the test. If you own or are underwriting industrial or flex space where computing is a supporting use, read the adopted text closely.
Large unincorporated tracts. If the moratorium is adopted, new data center or crypto mining applications on those sites would be on hold for up to a year. Price that time into any land marketed for those uses.
Power and water standards. Commissioners debated megawatt thresholds before choosing a broad definition for the pause. The regulations that follow could set those lines, which matters for sites near major electric and water capacity.
City versus county. Sites inside Murfreesboro, Smyrna or La Vergne are not covered. Expect developers to weigh city jurisdictions, and watch how each city handles data center zoning.
The notice. Because the Commission hearing must be advertised at least 15 days ahead, a legal notice is the earliest signal of when the final vote is set.
We will update this post when the county posts the amended resolution or sets the hearing. If you own land or industrial property in Rutherford County and want to talk through how this could affect your plans, contact the CBS Realty team.
